Construction Update – Hyegrove

January 2024

Estimated Construction Completion: Early 2025
Estimated Settlement: Early 2025

Milestones:

  • Bulk & detailed
  • earthworks complete
  • Shoring complete
  • Cranes 01 & 02 erected
  • Concrete Tower Boom erected
  • All pad footings & lift pits poured
  • Inground services complete
  • OSD tank slab and walls poured
  • OSD pump out pit and sewer tank installed

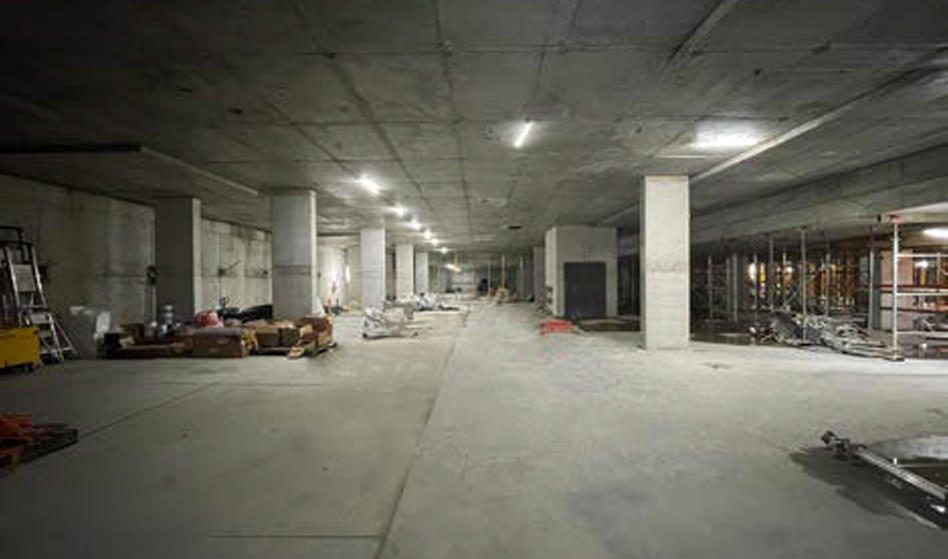

  • 100% of all slabs on the ground basement 03 have been poured
  • 100% of basement 02 concrete slabs have been poured
  • 60% of level 1 podium have been poured
  • 85% of level 1 podium formwork have been erected
  • Building C – levels 2 & 3 formed and poured
  • Building B – level 2 formwork commenced
  • Scaffold to building B up to level 03 erected, Scaffold to
  • building C up to level 4 erected.
  • Ramps between basement 02 to Level 1 are completed

Works planned on site for the first quarter of 2024:

  • 100% Basement 01 concrete slabs to be poured
  • 100% Podium levels to be poured
  • Building C – structure to be completed
  • Building B – structure to be completed
  • Building A – Levels 2, 3 & 4 to be poured. Level 5 formed
  • Building D – Levels 2 & 3 to be poured & Level 4 formed
  • Building E – Levels 2 & 3 to formed
  • Building F – Level 1 to be poured and level 2 to be formed
  • Basement 02 & 03 – Blockwork wall construction commenced
  • Basement 03 – High-Level Services rough-ins complete
  • Basement 02 – High-Level Services rough-ins commenced
  • Lift delivery
  • Basement Soffits & Columns painting completed
  • Basement Soffit Insulation to have commenced
  • Building C – above ceiling services rough-ins, internal and external wall framing, waterproofing, and window prep to commence
  • Building B – above ceiling services rough-ins, internal and external wall framing, waterproofing, and window prep to commence
  • Building A – Levels 2 & 3 above ceiling services rough-ins, internal and external wall framing, waterproofing, and window prep to commence

Programme

The key programme items are as follows:

  1. Site set up works Completed
  2. Demolition Completed
  3. Shoring Works Completed
  4. Bulk Earthworks Completed
  5. Detailed Excavation Completed
  6. Basement works In Progress
  7. Structure works In Progress
  8. Services rough in In Progress
  9. Window glazing In Progress
  10. Facade cladding In Progress
  11. Internal fit-out works In Progress
  12. Club Works Not Started
  13. Finishing works Not Started
  14. Landscaping Not Started
  15. Title registration Not Started
  16. Ready to settle –
