Construction Update – Audrey

October 2024

Estimated Construction Completion: Q4 2025
Estimated Settlement: Q4 2025

Click here to view a timeline of the build go to our 360 photo captured in July 2024

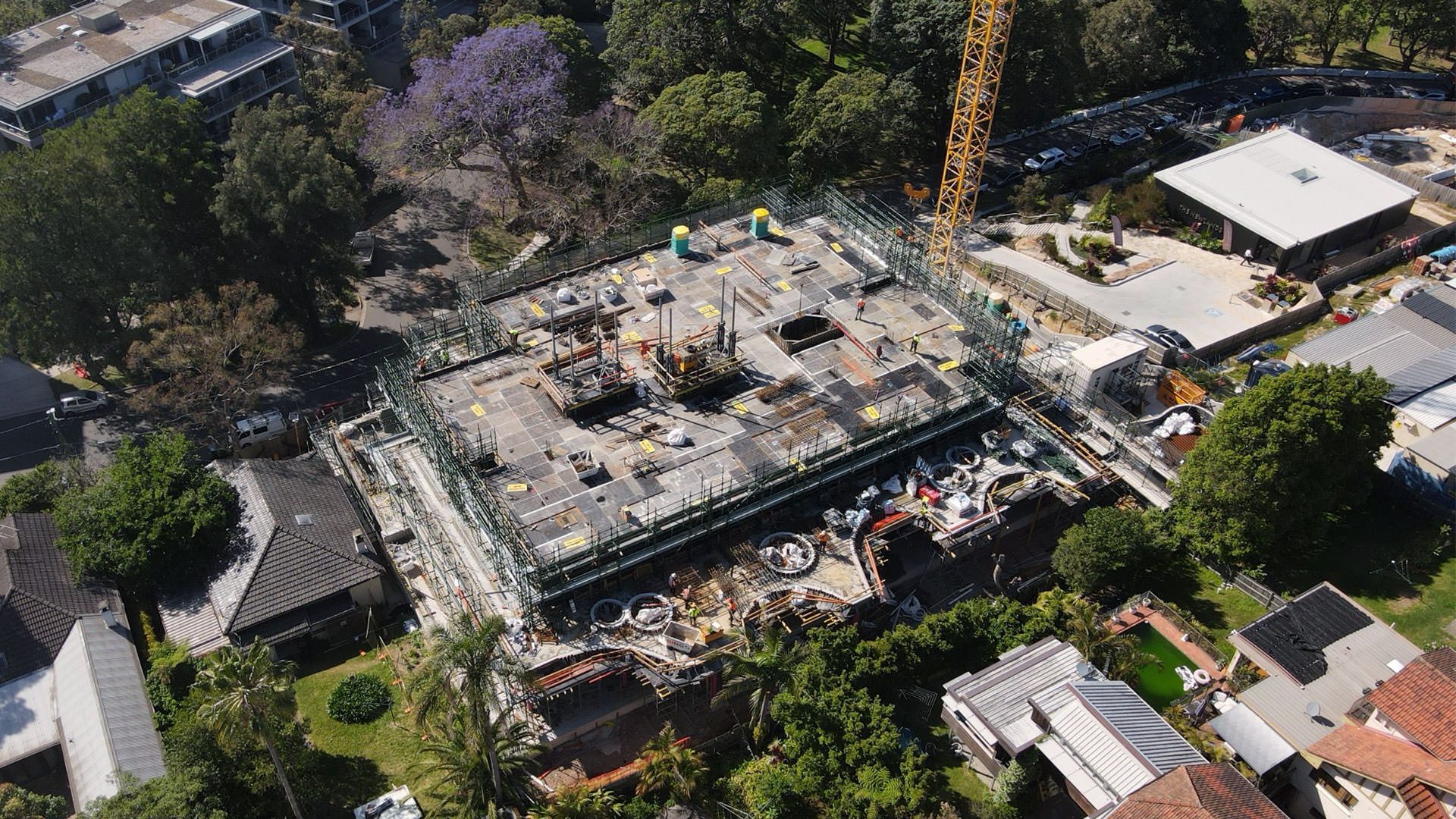

We wish to advise that building work continues to progress well. Please see the construction update below:

Milestones:

Works completed from Start to (July-September 2024) Quarter:

  • Bulk & Detail Excavation Complete
  • Shoring and Anchors Complete
  • Tower Crane Erected
  • In-Ground Services Complete
  • All pad footings and lifts poured
  • Basement Pump-Out Tank Poured & Pump Installed
  • Slab on Ground Poured
  • All Ramps Between and including Basement 4 – Ground Floor Poured
  • 100% of Basement Level 4 – Basement Level 1, Concrete Slabs Poured
  • 100% of Ground Floor to Level 2 Concrete Slabs Poured
  • Formwork, Reinforcement and Post Tension Working on Level 3
  • Scaffolding topped up to Level 3.
  • Sewer works complete from site boundary to main sewer.
  • Formwork stripping continues in basements levels 3, 2 & 1.
  • Overhead services installation commenced in basements 4, 3 & 2
  • Substation chamber poured
  • Fire Tank Poured

Works planned on site for the next quarter of 2024:

Works planned on site for the next quarter (October – December) of 2024:

  • Commencement of blockwork in the basement
  • Overhead services installation in basements 4, 3, 2 & 1 complete
  • Formwork, Reo, PT and Pour: (L3-L8)
  • Delivery of Lifts to Site.
  • Man, and Material Hoist installed.
  • Stripping of levels Ground Floor, Lower Ground Floor: (L1-L4)
  • Commencement of external framing and Installation of window and door sub jambs, subheads and sub sills. (Ground, Upper Ground Floor and L1)
  • Prepare wet areas for the commencement of waterproofing
    Ground and Upper Ground Floor
  • Commencement of internal framing Ground, Upper Ground Floor and Level 1
  • Installation of Lift 03

Works planned on site for quarter (January – March) of 2025:

  • Completion of blockwork in basement
  • Completion of services in basement
  • Completion of Rendering and Painting in Basement
  • Carpark fit out Commencement
  • Formwork, Reo, PT and Pour: (L9 – L17)
  • External framing and Installation of window and door sub jambs, subheads and sub sills: (L2 – L13)
  • External Cladding / Façade Finishes / Louvres & Balustrades: (L2 – L10)
  • Internal Services and fit out Commencement and On-going: (L2-L13)
  • Commencement of Lift 1 & 2 installation

Programme

The key programme items are as follows:

  1. Site set up works Completed
  2. Bulk excavation Completed
  3. Basement works Completed
  4. Structure works In-Progress
  5. Services rough in In-Progress
  6. Window glazing In-Progress
  7. Facade cladding Not started
  8. Internal fit out works Not started
  9. Finishing works Not started
  10. Landscaping Not started
  11. Title registration Not started
  12. Ready to settle –

Next Update: January 2025
