Construction Update – Audrey

July 2024

Estimated Construction Completion: Q4 2024
Estimated Settlement: Q3 2025

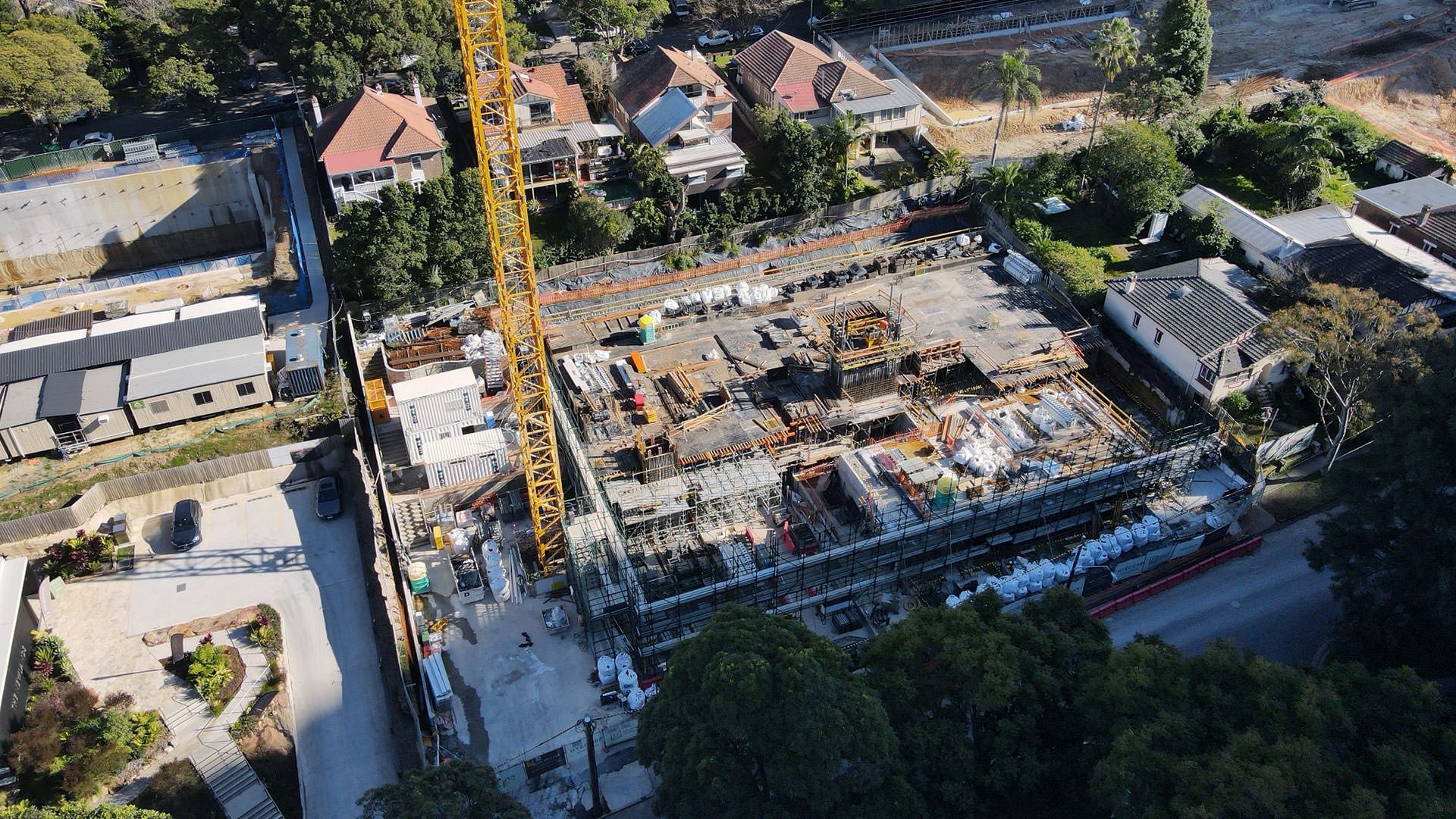

Click here to view a timeline of the build go to our 360 photo captured in July 2024

We wish to advise that building work continues to progress
well. Please see the construction update below:

Milestones:

  • Bulk and detail excavation complete.
  • Shoring and anchors complete.
  • Tower crane erected.
  • In-ground services complete.
  • All pad footings and lifts poured.
  • Basement pump-out tank poured and pump installed.
  • Slab on ground poured.
  • Ramp between Basement 4 and Basement 3 poured.
  • 100% of Basement Level 3 poured.
  • Ramp between Basement 3 and Basement 2 poured.
  • 100% of Basement Level 2 poured.
  • Ramp between Basement 2 and Basement 1 poured.
  • 100% of Basement Level 1 poured.
  • Ramp between Basement 1 and Ground floor poured.
  • 100% of Ground floor poured.
  • 100% of Upper Ground floor poured.
  • Perimeter scaffold installation up to and including Level 2.
  • Formwork deck to pour 1 Level 1 complete.
  • Sewer works complete from site boundary to main sewer.
  • Formwork stripping has commenced in Basement 3 and 2.
  • Overhead services installation commenced in Basements 3 and 2.
  • Undergrounding of overhead powerlines across Canberra Avenue frontage.
  • OSD tank and fire tanks to be poured.

Works planned on site for the next quarter of 2024:

  • Commencement of blockwork in the Basement.
  • Overhead services installation in Basements 4, 3, 2 & 1 complete.
  • Formwork, reinforcement, post tensioning and pour to Level 1, 2, 3, 4 & 5.
  • Man, and material hoist installed.
  • Stripping formwork from levels Ground Floor, Lower Ground Floor, Levels 1, 2, 3 & 4.
  • Commencement of external framing and installation of window and door sub jambs, subheads and sub sills. (Ground and Upper Ground floor).
  • Prepare wet areas for the commencement of waterproofing Ground and Upper Ground floor.
  • Commencement of internal framing Ground and Upper Ground floor.

Programme

The key programme items are as follows:

  1. Site set up works Completed
  2. Bulk excavation Completed
  3. Basement works Completed
  4. Structure works In-Progress
  5. Services rough in In-Progress
  6. Window glazing Not started
  7. Facade cladding Not started
  8. Internal fit out works Not started
  9. Finishing works Not started
  10. Landscaping Not started
  11. Title registration Not started
  12. Ready to settle –

Next Update: October 2024
